dk.
All work

Verizon · Kirke Platform · 2023

Scheduling errors were invisible — until they cost millions.

Redesigned 3 core workflows and delivered 16 new features for a national telecom maintenance platform — reducing preventable conflicts and eliminating the tribal knowledge barrier for 3,000+ field technicians.

UX / UI Designer9 monthsTelecom · Enterprise Operations
ImportantUPLOAD_HERO_DIAGRAMKirke platform lifecycle — Create Plan → Schedule → Notify → Track

40%

Reduction in preventable scheduling conflicts

50%

Fewer form abandonment incidents

16

New features designed and delivered

Executive Summary

A platform as high-stakes as the infrastructure it manages.

Kirke is the operations backbone for maintenance scheduling at Verizon's national scale — coordinating field crews, network elements, maintenance windows, and outage communications across thousands of simultaneous activities. When it works, it's invisible. When it doesn't, field crews are dispatched to the same site, SLA penalties are triggered, and customers go dark without warning.

Over 9 months, I worked across three parallel tracks: fixing what was broken (13 inconsistent forms with errors that disappeared after 3 seconds), redesigning the core (transforming a single-page monolith into a guided, step-by-step scheduling flow), and building what was missing (16 new features, including a Multi-Day Maintenance dashboard for activities spanning multiple days and locations).

The redesigned platform reduced preventable scheduling conflicts by 40%, improved form completion rates by 40%, and cut plan creation time by 30%. A distributed engineering team across two time zones received a 180+ screen specification library that cut design QA cycles by a third.

Project Details

Timeline
Feb 2023 – Nov 2023 (9 months)
Platform
Enterprise Operations · B2B · Telecom
Scope
Error system redesign · Core workflow redesign · New feature delivery
Role
UX / UI Designer — discovery to engineering handoff
Client
Verizon (via Incedo Inc)

Project Impact Overview

Dimension

Before

After

Error visibility

Hidden on hover; toast disappeared in 3 seconds

Real-time inline validation with categorised messages

Form completion rate

Monolithic layout; session timeouts; 50% abandonment

Guided step flow; 40% task completion improvement

Plan creation speed

No baseline measurement

30% faster post-launch

Scheduling conflicts

Discovered post-dispatch — after crews were en route

Detected inline before confirmation; 40% reduction

Multi-day scheduling

Separate request per date/location; fragmented approvals

Unified MDM dashboard (incremental rollout)

The Problem

"The system required tribal knowledge to operate — and nobody wanted to touch the forms."

Synthesized from 19 user interviews and design workshop findings, Q1 2023.

ImportantUPLOAD_WORKSHOP_BOARDDesign workshop board / affinity map — pain points by user role
Workshop synthesis from onsite discovery sessions. Pain points were clustered and prioritised using the Eisenhower Matrix, which surfaced error handling and form complexity as the highest-impact, highest-urgency areas.

Who it affected

Operations Managers

Updating a schedule felt like defusing a bomb.

  • Error messages vanished after 3 seconds — no recovery path, no actionable guidance.
  • 13 forms with inconsistent validation: no mental model carried between them.
  • Session timeouts on long forms lost all progress; users restarted from scratch.
Field Technicians

We found out about conflicts after we drove to the site.

  • Scheduling overlaps weren't surfaced during request creation — only discovered post-dispatch.
  • Multi-day activities required separate requests per date, multiplying approval delays.
  • Outage notifications arrived too late or not at all, triggering customer escalations.
Business

The cost was measurable and preventable.

  • Missed scheduling conflicts triggered SLA penalties — a direct, quantifiable cost.
  • Fragmented multi-day maintenance approval chains delayed project starts.
  • Customer escalations from poor outage communication generated persistent support overhead.

Track 01 · Optimising Existing Features

13 forms. 13 chances for a user to give up.

Kirke contained approximately 13 forms — from creating maintenance requests to managing network elements. Each had its own validation behaviour: some errors appeared only on hover, some surfaced a toast notification that disappeared after a few seconds, and none provided actionable recovery guidance. Users completing long, multi-step scheduling forms would encounter a problem, lose the error state, and abandon the form entirely.

Research approach

Method: Eisenhower Matrix prioritisation + competitive design pattern analysis

Scope: Validation patterns across 13 forms; error handling conventions from leading enterprise tools

← Before · Broken error model — 13 inconsistent forms

  • 1Toast message: "Please fill the highlighted fields." — disappeared after 3 seconds
  • 2Errors only visible on hover — invisible on touch devices and quick scanners
  • 3No error categorisation — all failures looked and read the same
  • 4No actionable recovery guidance — users couldn't tell what to fix or why
  • 5Inconsistency across forms — no mental model carried between screens

The vanishing toast was the single highest-friction error pattern — users who missed it had no recovery path.

After · Standardised validation system

  • 1Real-time inline validation as users complete each field
  • 2Persistent, visible error states with colour coding and iconography
  • 34 error categories: Validation, Input, Network, Access — targeted messages per type
  • 4Tooltip guidance surfaced on complex fields before errors occur
  • 5Consistent pattern across all 13 forms — one mental model throughout the platform

Error categorisation was the strategic win: it gave engineers a taxonomy and users language to describe problems.

CriticalUPLOAD_TRACK1_BEFOREError handling before — form with disappearing toast notification
The disappearing toast. Users who blinked at the wrong moment had no recovery path.

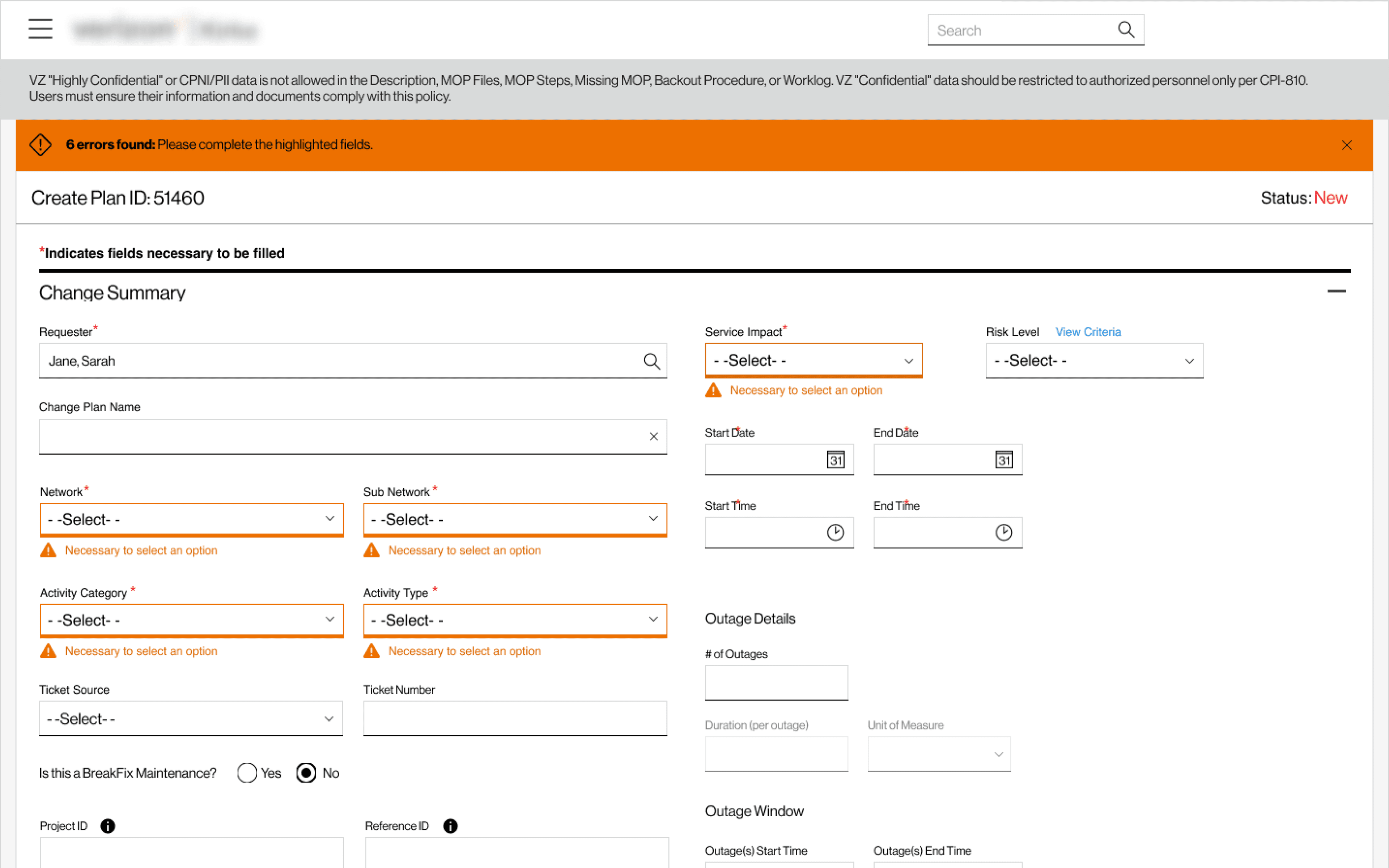

CriticalUPLOAD_TRACK1_AFTERError handling after — real-time inline validation with categorised messages
Real-time inline validation. Errors persist, categorise, and guide — they don't disappear.

20–30%

Faster error resolution post-launch

50%

Reduction in form abandonment

4

Error categories for targeted messaging

Track 02 · Redesigning Core Workflows

A maintenance request form shouldn't feel like a tax return.

The Create Plan and Request flows were the highest-frequency experiences on Kirke — touched by every user, multiple times a day. They were single-page layouts with all fields simultaneously visible, performance issues from multiple concurrent lookups, and a critical design flaw: the most important input (network element selection) appeared mid-form with no setup context. Long completion times regularly triggered session timeouts. Through 19 structured user interviews and journey mapping across 4 role types, the same theme emerged: users dreaded opening these forms.

Research approach

Method: 19 user interviews structured by role · User journey mapping · GUI heuristic evaluation

Scope: 10 Requesters · 4 Implementers · 1 Administrator · 4 Mixed-Role users

← Before · Monolithic form — all fields, all at once

  • 1All fields visible simultaneously — no sense of progress or priority
  • 2Heavy concurrent lookups caused slow load times and interaction lag
  • 3Critical network element field buried mid-form with no setup context
  • 4Long completion time increased session-timeout risk — progress lost on expiry
  • 5No progress indicator — users couldn't gauge how far through they were

The session-timeout risk was the most cited frustration in interviews — users lost 20+ minutes of input with no warning.

After · Guided step-by-step flow

  • 1Step-by-step flow modelled on e-commerce checkout — one focus area per step
  • 2Asynchronous multipart loading — each step fetches only what it needs
  • 3Critical inputs moved to step 1 with full context before dependent fields appear
  • 4Persistent progress indicator throughout — users always know where they stand
  • 5Smart defaults and 80/20 field prioritisation reduce decision fatigue

The e-commerce checkout mental model tested immediately in usability sessions — users described the new flow as "obvious."

CriticalUPLOAD_TRACK2_BEFOREForm redesign before — monolithic single-page scheduling form
The original form. All fields, all at once. The network element selector was buried in the middle with no prior context.
CriticalUPLOAD_TRACK2_AFTERForm redesign after — guided step-by-step scheduling flow
The redesigned flow. One focus area per step, progress always visible, critical inputs surfaced first.
ImportantUPLOAD_TRACK2_NAVIGATIONNavigation concept explorations — 3 options: side nav, checklist, expandable
Early navigation concept exploration. Option 3 (expandable) tested best — it let users cross-reference information between steps without losing their place.

85%

Of users found the new experience easier to navigate

40%

Task completion improvement post-launch

30%

Faster plan creation

Track 03 · Designing New Features

One job. Ten requests. Zero visibility.

Multi-day maintenance activities — a crew working across multiple dates and locations on a single project — required a separate Kirke request for every date/location combination. A 5-day job across 3 locations meant 15 requests, 15 approval chains, and no aggregated view tying them together. Operations managers tracked complex jobs in spreadsheets alongside Kirke. Customer outage communication was equally fragmented. This was the most-cited improvement opportunity across stakeholder workshops.

Research approach

Method: Collaborative discovery workshops · Business requirements analysis · Technical feasibility scoping

Scope: Stakeholders · Business teams · Product Owners · Architects · Development team

Two models explored

Scenario A

Continuous

One request spanning multiple days. Simpler tracking, unified workflow. Best for activities with no inter-day dependencies.

Scenario B

Chunked

Separate requests linked by a parent Multi-Day Plan ID. Individual day-level tracking with full auditability. Best for complex activities requiring per-day sign-off.

← Before · Fragmented model — one request per date/location

  • 1Each date/location combination generated a separate, unlinked request
  • 2Multiple approval chains for a single job — delays multiplied with scale
  • 3No aggregated view of a multi-day job — operators used external spreadsheets
  • 4Fragmented outage notifications — customers received disconnected alerts
  • 5Conflict detection was per-request, not across the full multi-day scope

Operations managers managing 5-day jobs tracked status across 15+ separate Kirke requests by memory.

After · Proposed: Unified MDM Dashboard

  • 1Centralised dashboard grouping all requests under a Multi-Day Plan ID
  • 2Consolidated approval workflow — one chain for the entire activity
  • 3Aggregated conflict detection across the full scheduling window
  • 4Grouped outage notifications — customers receive one coherent communication
  • 5Equipment schedule view and export for custom reporting

Labelled "Proposed" intentionally — the design shipped incrementally, not as a single dashboard release.

CriticalUPLOAD_TRACK3_ARCHITECTUREMDM current vs proposed architecture — fragmented requests vs unified plan
Current vs proposed architecture. Left: 15 unlinked requests for a 5-day, 3-location job. Right: one Multi-Day Plan ID with linked requests, shared approval chain, and aggregated conflict view.
CriticalUPLOAD_TRACK3_DASHBOARDMDM dashboard design — unified view of all requests under a Multi-Day Plan
The proposed MDM dashboard. Stakeholders were aligned on the direction. Backend constraints required it to be built incrementally — the dashboard became the north star, not the first release.

Honest outcome

The dashboard was positively received by product and business stakeholders. Backend architecture then introduced a hard constraint: MDM had to be split into smaller development stories for incremental delivery. The dashboard was parked temporarily — not cancelled — while constituent pieces were built. The design became the north star for incremental delivery rather than a single-release artefact.

16

New features designed and delivered in total

8

Stakeholder workshops run across the engagement

2

Multi-day scheduling scenarios designed end-to-end

Reflection

High-stakes systems teach you to design for what goes wrong.

Failure modes are the product.

On most platforms, the happy path is 90% of design effort. On Kirke, the most valuable work happened in edge cases — what happens when an error vanishes before a user reads it, when two crews are dispatched to the same site, when a multi-day job has no single tracking view. Investing in failure modes is what produced the 40% conflict reduction.

Research credibility unlocks design authority.

The Eisenhower Matrix prioritisation and 19-interview programme weren't just research activities — they were the mechanism that gave design a seat at the roadmap table. Stakeholders trusted design decisions because they could trace them directly to user evidence. Evidence earns influence.

Technical constraints are a design input, not an obstacle.

The MDM dashboard pivot from a unified release to incremental delivery wasn't a failure. It was a product design decision. Adapting the delivery strategy while preserving the design vision — and communicating that distinction clearly to stakeholders — is what kept the north star intact for future sprints.

Craft & Delivery

180+

Screens delivered with shared interaction patterns

8

Stakeholder workshops facilitated

16

New features designed end-to-end

2 TZs

Engineering team served via interaction specification library
